Government Hospital Kandiyaperi, Tirunelveli
August 2021Joint Site Inspection with DTCP Joint Director, PWD, Consultants & Contractor on 05.08.2021
August 2021Grade concrete pouring work has been completed on 10.08.2021.
August 2021EE, PWD visited the site for monitoring quality and progress of construction works. (Dt. 13.08.2021)

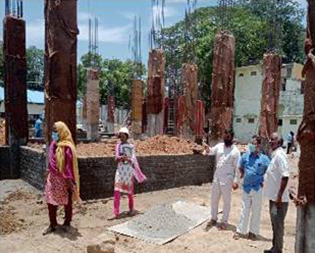

August 2021Environment upgradation activity: 21 numbers of trees are planted at hospital campus. (Dt. 13.08.2021)
August 2021CE, PWD visited the site for monitoring quality and progress of construction works. (Dt. 14.08.2021).
August 202175th Independence Day celebrated at the construction site. (dt. 15.08.2021)
August 2021The Medical Camp was conducted by the Hospital Authority to vaccinate the labours & staffs of the construction project. (Dt. 21.08.2021)

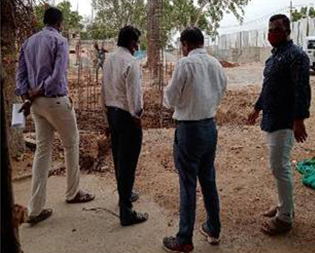

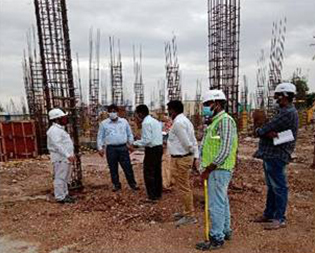

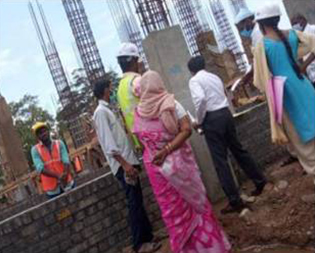

August 2021Site inspection by AEE, PWD on 25.08.2021
August 2021New PWD S.E. Er. Sathyamoorthi visit our site and he has planted trees in our site campus and we are held test for Fly ash brick in presence of SE. Test result for fly ash brick 8.65N/mm2 on 28.08.2021.
September 2021Earth backfilling and consolidation work started on 01.09.2021
September 2021The Quality Control team, PWD visited the site for monitoring the quality and progress of the construction works. (Dt. 02.09.2021)

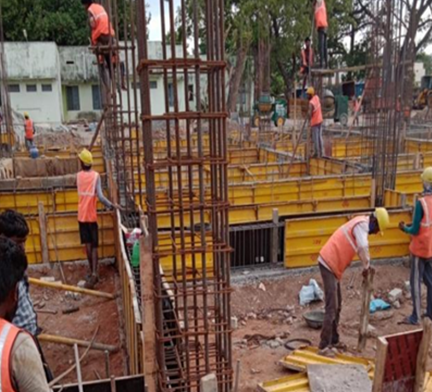

September 2021Ramp area Ist flight slab reinforcement work under progress. (Dt. 03.09.2021)
September 2021Flooring P.C.C. work & HUME pipe laying work has been started on 06.09.2021.
September 2021Consultant team combining DTL, MEP Engineers has visited the site and discussed with PWD execution team / Contractor for MEP. (Dt. 08.09.2021)
September 2021The new EE, PWD visited the site for monitoring the quality and progress of the construction works. (Dt. 18.09.2021)

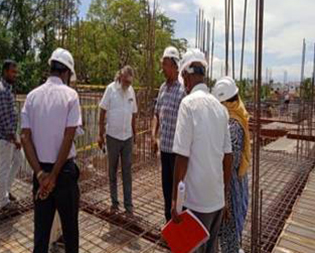

September 2021Meeting held with PWD, PMC & Contractor to expedite the ground floor slab concreting. (Dt. 23.09.2021)

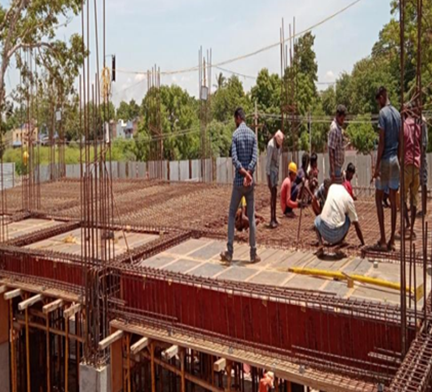

September 2021Verifying of ground floor roof slab reinforcement work under progress. (Dt. 24.09.2021)
September 2021The Quality Control team, PWD visited the site for monitoring the quality and progress of the construction works. (Dt. 30.09.2021)
Work progress as on August 2021

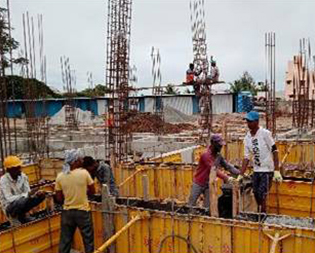

August 2021Grade beam pouring concrete work under progress Dt. 01.08.2021
August 2021Steel reinforcement has been checked and Concrete pouring work for grade beam under progress Dt. 07.08.2021

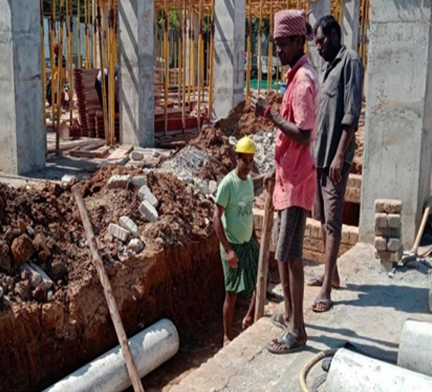

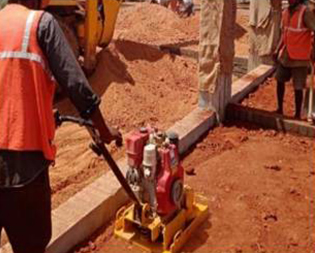

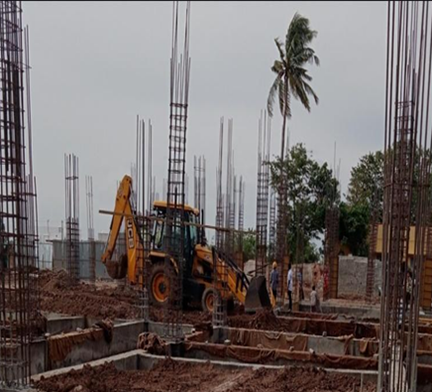

August 2021Excavated earth back filling up to grade beam in completed areas under progress Dt. 11.08.2021

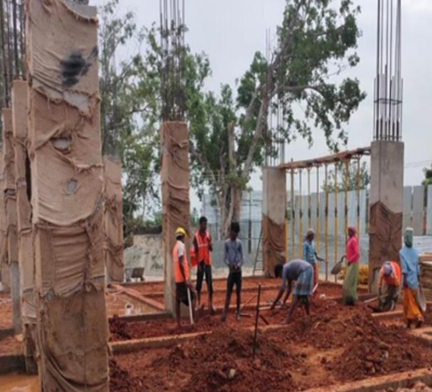

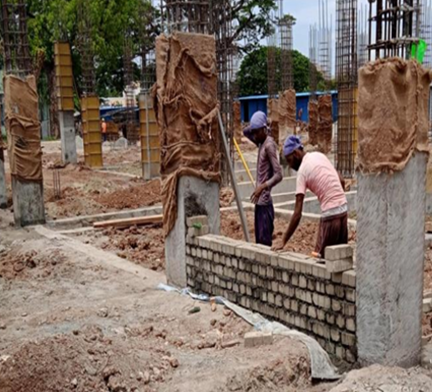

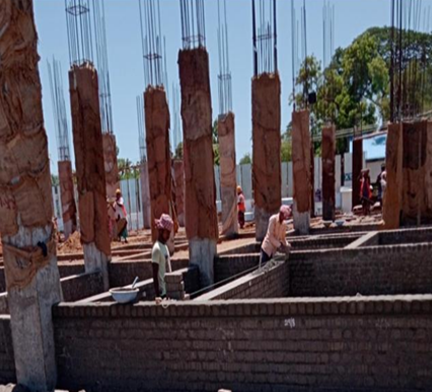

August 2021Brick work for basement walls up to DPC level work under progress Dt. 19.08.2021
August 2021Gravel filling work on basement wall constructed areas under progress Dt. 24.08.2021

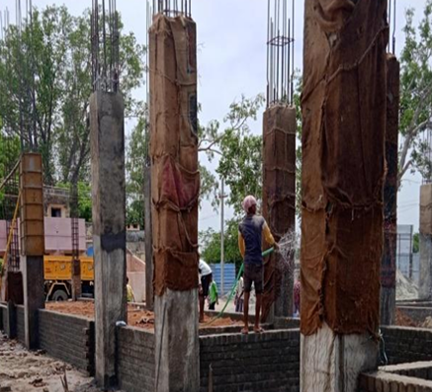

August 2021Concrete pouring work for column lift up to roof level as grid X-axis 11 to 15, Y-axis 1.2 to 2.1 work under progress Dt. 31.08.2021
Work progress as on September 2021
September 2021Gravel filling and water consolidation work on basement wall constructed areas Dt. 02.09.2021

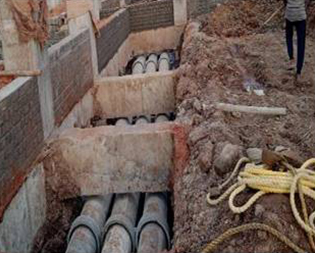

September 2021Hume laying work for rain water and sewage water from O.T.S to building outside Dt. 09.09.2021

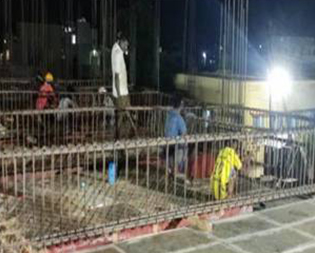

September 2021Concrete pouring work for staircase first waist slab and landing Dt. 13.09.2021

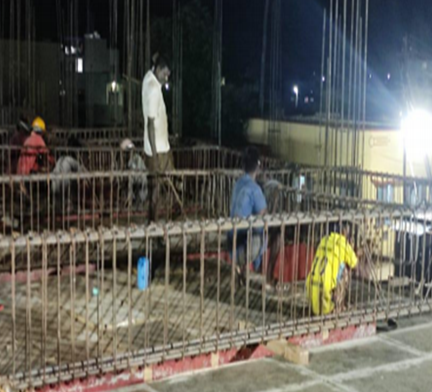

September 2021Steel rods hoisting, placing & binding work for ground floor roof beams as grid X-axis 1 to 13, Y-axis 10 to 16 Dt. 20.09.2021

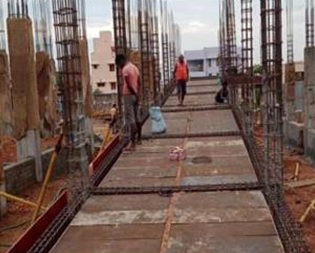

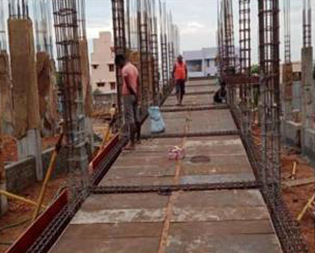

September 2021Form work for ground floor roof slab work under progress Dt. 23.09.2021
September 2021
