Government Hospital Velamapalayam, Tiruppur

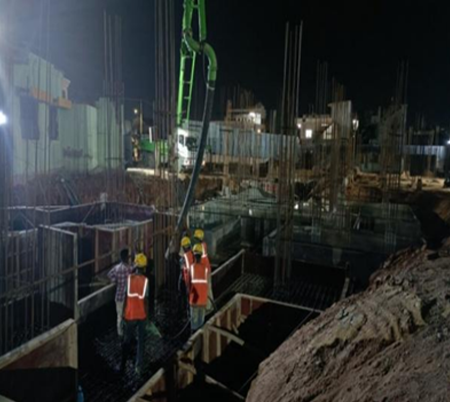

August 2021Concrete pouring on footings completed. (Dt. 02.08.2021)
August 2021The Medical Camp was conducted by the Hospital Authority to vaccinate the labours & staffs of the construction project. (Dt. 04.08.2021)
August 2021Quality Control team, PWD visited the site for monitoring quality and progress of construction works. (Dt. 06.08.2021)
August 2021Discussion with AE, PWD & Nodal Officer. (Dt. 13.08.2021)

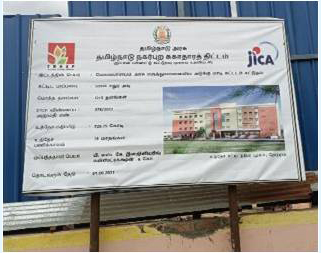

August 2021Detailed project display boards in Tamil & English language are provided in the site. (Dt. 14.08.2021)

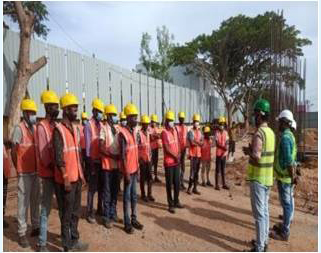

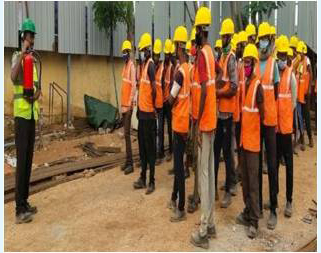

August 2021Safety meeting conducted by the Consultants for the site labours. (Dt. 26.08.2021)
September 2021PWD Executive engineer general site visit and inspected Footing reinforcement works. (Dt. 08.09.2021)

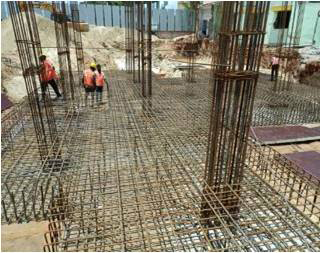

September 2021Footings level concrete completed. (Dt. 11.09.2021)
September 2021As per the agreement conditions, Environmental tests taken 1. Ambient air quality test 2. Ambient noise level test 3. DG Static emission test. (Dt. 14.09.2021)
September 2021Newly posted Executive engineer & Assistant Executive engineers, PWD visited the site. (Dt. 18.09.2021)
September 2021Discussion points are : 1. Personal protective equipments 2. Workers welfare facilities 3. Job hazards and precautions. (Dt. 11.09.2021)
September 2021Safety training conducted by safety engineer for workers & supervisors 1.Fire fighting training. 2.Manual handling and material shifting. (Dt. 28.09.2021)
September 2021PWD quality control EE, AEE,AE visited the site. Some instructions given to the contractors to follow up. (Dt. 27.09.2021)
Work progress as on August 2021

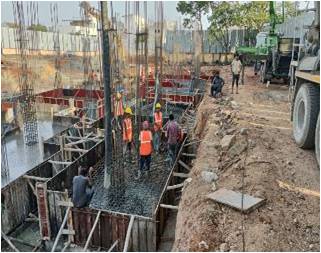

August 2021Shuttering work for Footing Dt. 02.08.2021

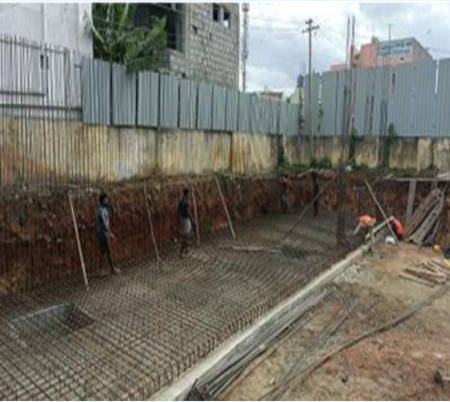

August 2021UG sump base slab reinforcement work under progress Dt. 05.08.2021

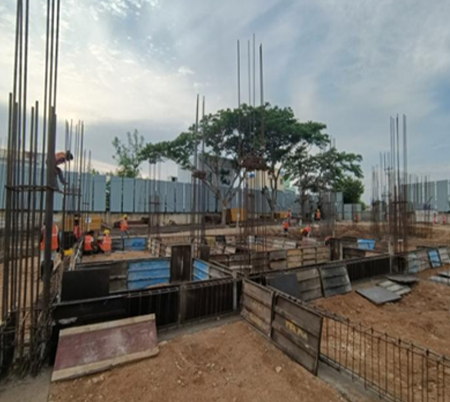

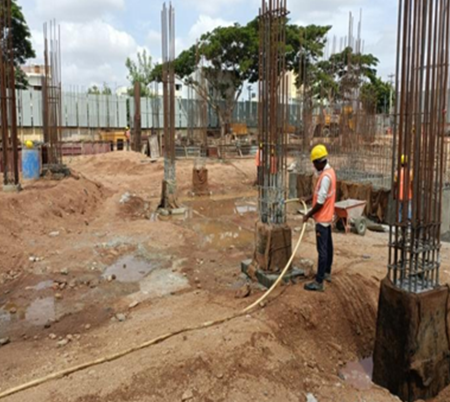

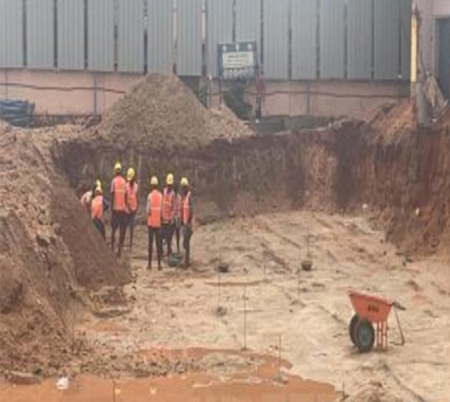

August 2021Hard rock strata removal from foundation areas under progress Dt. 11.08.2021

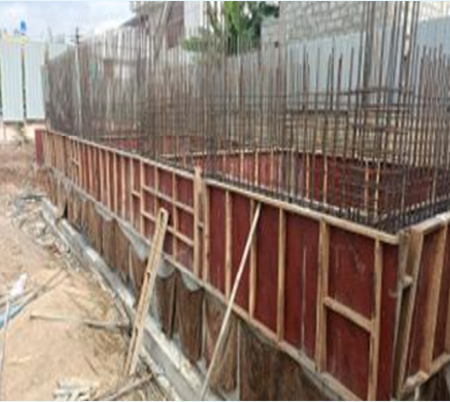

August 2021UG static water tank with pump house wall shuttering work under progress Dt. 20.08.2021

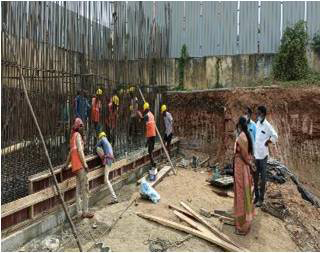

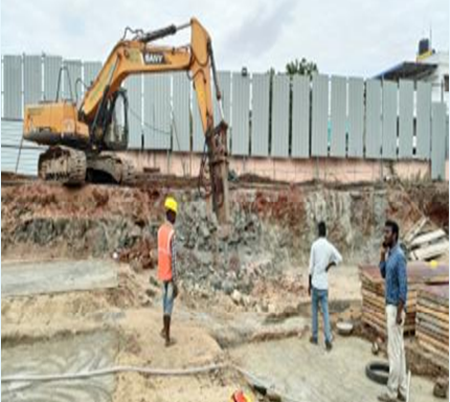

August 2021Existing Building demolition work and Excavation work under progress Dt. 24.08.2021
August 2021Bar bending and rebar binding work for footing under progress Dt. 28.08.2021
Work progress as on September 2021
September 2021Footing marking with total station Dt. 01.09.2021

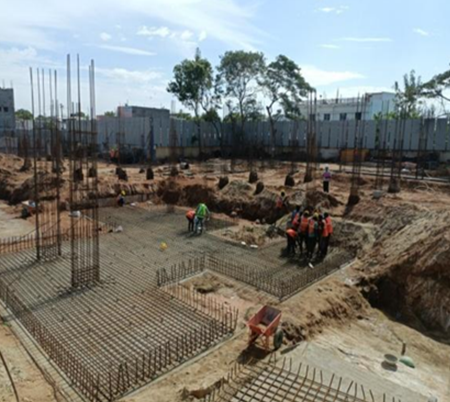

September 2021Raft footing bottom mat under progress Dt. 07.09.2021
September 2021RCC concrete pouring for footings (M25 Grade) CF6, F6, F8, F1, CF5, F3, F3, RF8 Completed Dt. 11.09.2021

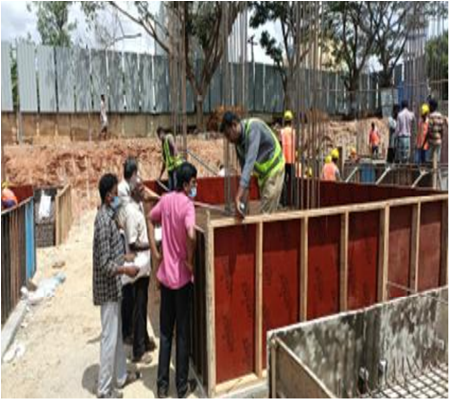

September 2021Grade beam shuttering work under progress Dt. 18.09.2021
September 2021Curing work for all concrete surface under progress Dt. 23.09.2021
September 2021
