Government Rajaji Hospital, Madurai

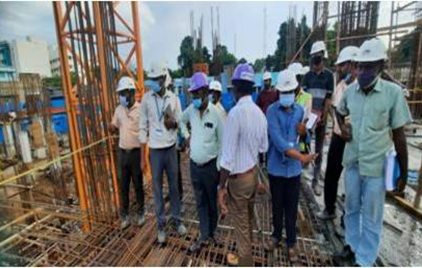

August 2021JICA Representative - Site Visited on 03.08.2021
August 2021JICA Representative - Site Visited on 03.08.2021
August 2021Safety meeting conducted by the Safety Engineer for the site labours. (dt. 04.08.2021)

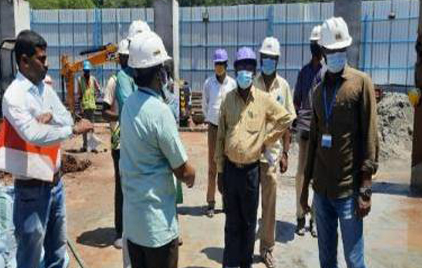

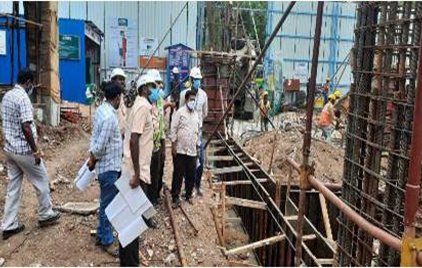

August 2021CE & EE, PWD visited the site for the discussions on the sump location. (dt. 13.08.2021)

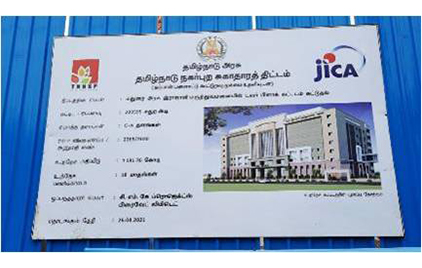

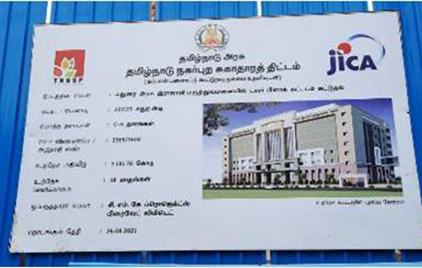

August 2021Detailed project display boards in Tamil & English language are provided in the site. (dt. 14.08.2021)
August 202175th Independence Day celebrated at the construction site. (dt. 15.08.2021)

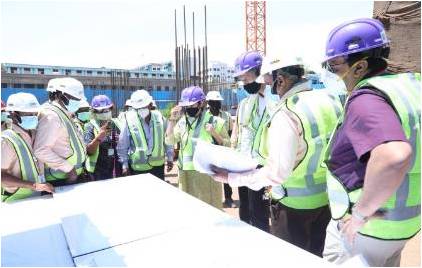

August 2021The Quality Control team, PWD visited the site for monitoring the quality and progress of the construction works. (dt. 17.08.2021)
August 2021First Aid Training Programme conducted by GRH Hospital Authority to the Safety Engineers & Site Engineers. (dt. 18.08.2021)
August 2021Quality Control team, PWD visited the site for monitoring quality and progress of construction works. (dt. 24.08.2021)
August 2021The Medical Camp was conducted by the Hospital Authority to vaccinate the labourer & staff of the construction project. (dt. 28.08.2021)

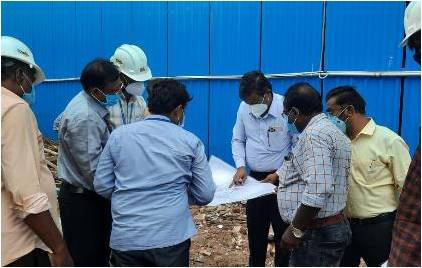

September 2021From Mukesh & Associates - DTL Site inspection & progress review meeting on 07.09.21 & 08.09.21.
September 2021The Medical Camp was conducted by the Hospital Authority to vaccinate the labourer & staff of the construction project. (dt. 10.09.2021)
September 2021GF roof slab concrete partially achieved. (dt. 10.09.2021)
September 2021New EE, PWD - Er. AYYA SAMY has visited the site and reviewed the progress of work. (Dt. 16.09.2021)
September 2021EE, PWD has discussed with contractor for agreement related queries. (dt. 25.09.2021)
September 2021For site workers DPH conducted the General health check up. (dt. 29.09.2021)
September 2021Contractor discussed with Dean, clearance for road side shop hindrance. (Dt. 30.09.2021)
Work progress as on August 2021

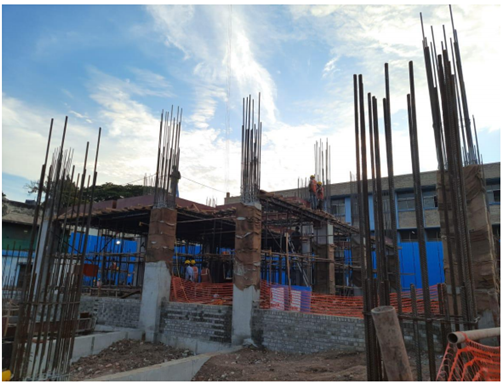

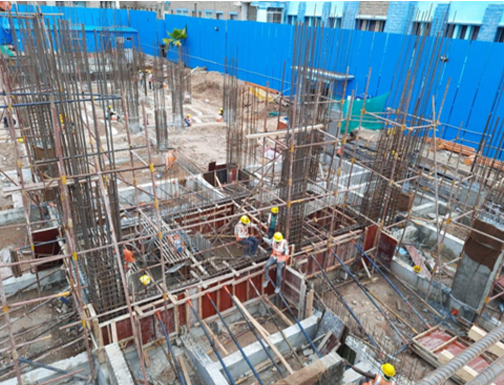

August 2021Grade beam & Column, RCC wall form work & Basement level brick work,Staging work for GF-Roof slab Dt. 04.08.2021

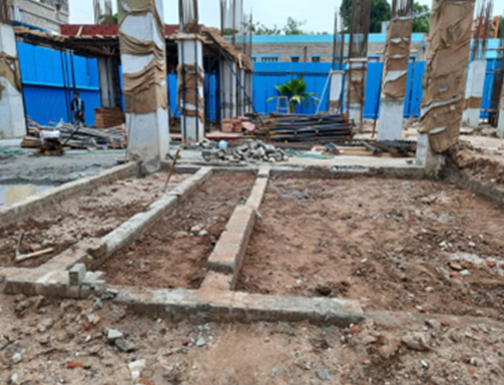

August 2021RF-3 Grade beam rebar and column 1st lift form work Dt. 11.08.2021

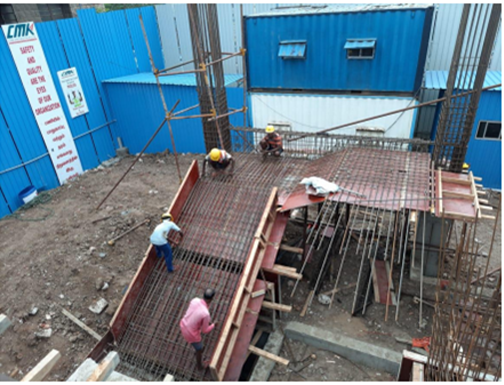

August 2021Ramp slab first flight under progress Dt. 19.08.2021

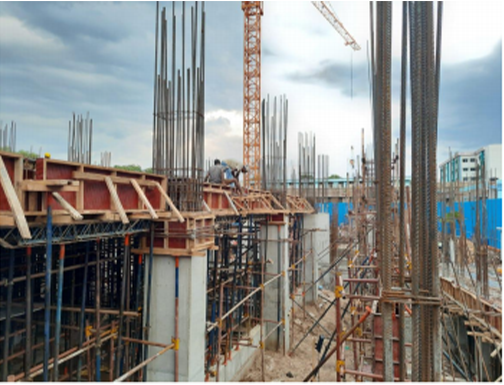

August 2021Concrete work for GF-Roof slab shuttering and rebars work under progress Dt. 25.08.2021
August 2021Staircase form work under progress Dt. 27.08.2021

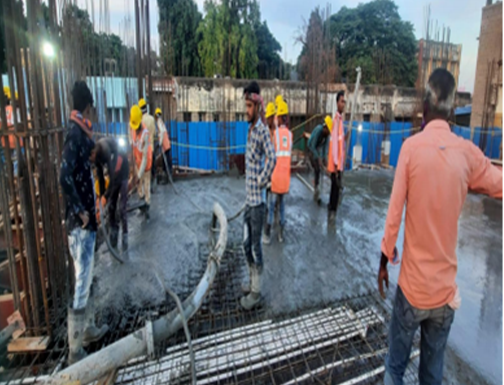

August 2021Ground floor roof slab concreting work under progress Dt. 29.08.2021
Work progress as on September 2021

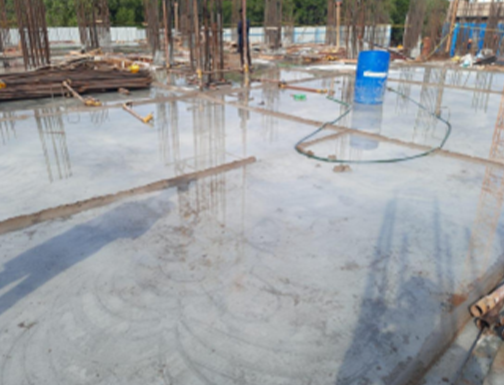

September 2021GF roof slab concrete completed and curing work under progress Dt. 01.09.2021

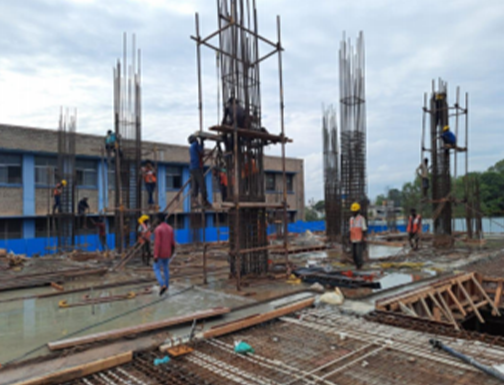

September 2021FF Column 1st lift rebar work under progress Dt. 04.09.2021
September 2021GF roof slab concrete work Grid No: X1-X7.1 to Y4.1-Y8 Dt. 10.09.2021

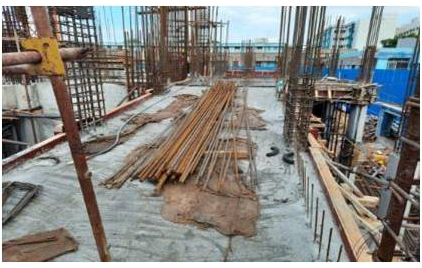

September 2021GF Roof slab de-shuttering work under progress Grid no.: X1-X7.1 to Y1-Y3 Dt. 18.09.2021
September 2021Column concrete works - 6 Nos.Grid no: X6-Y12, Y11.1, X12-Y12.2, X6.1-Y11.1 Dt. 25.09.2021
September 2021
